Tuesday, September 30, 2008

Field Report Tuesday September 30, 2008

Tuesday September 30, 2008
70's F overcast, 50's F overnight, rain at times heavy over past few days.

Water and sewer lateral installed all lots past porch/Infrasource trench location.

Sub-contractors report low supplier inventory creating problems, one piece tub/shower units have long lead times.

Lot 1 through 7;
Insulation installed lots 1, 2, 3 & 7
Drywall hung, finish in progress lots 4, 5 & 6

Lot 14 through 19;
Rough sanitary plumbing in progress.
Relocate sanitary plumbing to 2nd floor hall bathroom to match lots 1 through 7 and 20 through 26 with header at kitchen/living room passage.

Lots 20 through 26;
Kitchen and vanity installation in progress lots 20, 21 & 22
Furnace and HWH installation in progress
Finish electric and plumbing fixtures in progress.

Lot 17, plumbing to be relocated to eliminate ceiling lump.
Lot 20 kitchen
Lot 21 kitchen
Lot 22 kitchen
Lot 6 drywall
Lot 5 drywall
Lot 4 drywall
Lot 3 insulation
Lot 2 insulation
Lot 1 insulation

Wednesday, September 24, 2008

Field Report Wednesday September 24, 2008

Wenesday September 24, 2008
Low 70's F dry overcast, 50's F overnight.
Forecast wind and rain "nor-easter" to arrive Thursday afternoon.

Lot 4 insulation complete
Lot 5 drywall on site
Lot 6 drywall on site
Lot 3 fire saffing complete
Lot 2 fire saffing complete
Lot 1 fire saffing complete

Tuesday, September 23, 2008

Field Report Tuesday September 23, 2008

Tuesday September 23, 2008
Low 70's F, dry 50's F overnight.
Forecast wind and rain Thursday evening through Friday.

Sewer and water past porch wall in progress 3rd Street and Union Street.

Sanitary plumbing interior rough in progress lots 19 & 18.

Lot 26 sewer and water
Lot 25 sewer and water
Lot 24 sewer and water in progress
Lots 20 through 26
Lot 13 sewer and water trench fill
Lot 12 sewer and water trench fill
Lot 11 sewer and water trench fill
Lot 10 sewer and water trench fill
Lots 13 through 8
Lot 19 sewer and water
Lot 18 sdewer and water trench fill
Lots 19 through 14
Lot 19 rough plumbing progress
Lot 18 rough plumbing progress

Field Report Monday September 22, 2008

Monday September 22, 2008

Mid 70's F dry, 50's F overnight.

Forecast 70's F dry through Friday, with showers at weekend.

3rd Street prep for sewer installation.

Monday, September 22, 2008

Field Report, Friday September 19, 2008

Friday September 19, 2008
Low 70's F during day, 50's F overnight, dry.

Insulation in progress lots 7, 6 & 5

Lot 7
Lot 6
Lot 5

Thursday, September 18, 2008

Project Meeting Wednesday September 17, 2008

Wednesday September 17, 2008

Mid 70's F clear, 50's F overnight, TS Ike tracked west producing dry condition in eastern Pennsylvania.

Forecast low 70's for next 5 days and dry.

54% complete, payment voucher approved and signed (previously signed by Dawson, McGuire and WDC).

Attendance;

James Thomas; Union Square Homes

Harold Thomas; Union Square Homes

Jihad Ali ; Union Square Homes

Dan Thomer; WDC Construction

Lisa Gaffney; CEDA

Michael Washington; OHCD

Harry Ackroyd; R&V for OHCD

Colin Dawson RA; CDRA

Distribution all in attendance and;

John Paczewski; PHFA

Kevin Maguire; for TRF

Assistant Director, Linda Hill; OHCD

Progress;

4th Street

Lot 1; Siding and porch brick masonry complete, rough mechanicals complete

Lot 2; Siding and porch brick masonry complete, rough mechanicals complete

Lot 3; Siding and porch brick masonry complete, rough mechanicals complete

Lot 4; Siding and porch brick masonry complete, rough mechanicals complete, air sealing complete.

Lot 5; Siding and porch brick masonry complete, rough mechanicals complete, air sealing complete, insulation in progress.

Lot 6: Siding and porch brick masonry complete, rough mechanicals complete, air sealing complete, insulation in progress.

Lot 7; Siding and porch brick masonry complete, rough mechanicals complete, air sealing complete, insulation in progress.

Union Street, north side;

Lot 8; Siding and porch brick masonry complete, patio door installed.

Lot 9; Siding and porch brick masonry complete, patio door installed.

Lot 10; Siding and porch brick masonry complete, patio door installed.

Lot 11; Siding and porch brick masonry complete, patio door installed.

Lot 12: Siding and porch brick masonry complete, patio door installed.

Lot 13; Siding and porch brick masonry complete, patio door installed.

Union Street, south side;

Lot 14: Siding and porch brick masonry complete, patio door installed.

Lot 15; Siding and porch brick masonry complete, patio door installed.

Lot 16; Siding and porch brick masonry complete, patio door installed.

Lot 17; Siding and porch brick masonry complete, patio door installed.

Lot 18; Siding and porch brick masonry complete, patio door installed.

Lot 19; Siding and porch brick masonry complete, patio door installed.

3rd Street;

Lot 20; Siding complete, drywall prime and paint, bathroom and vestibule tile complete, kitchen tile complete

Lot 21; Siding complete, drywall prime and paint, bathroom and vestibule tile complete, kitchen tile complete

Lot 22; Siding complete, drywall prime and paint, 2nd floor bathroom and vestibule tile complete, kitchen tile complete

Lot 23; Siding complete, drywall prime and paint, 2nd bathroom and vestibule tile complete, kitchen tile in progress

Lot 24; Siding complete, drywall prime and paint.

Lot 25; Siding complete, drywall prime and paint.

Lot 26; Siding complete, drywall prime and paint in progress.

Anticipated Progress next week weather permitting;

Lots 1 through7; Insulation complete, drywall hung lots 7, 6 & 5.

Lot 8 through 13; Rough mechanicals in progress.

Lot 14 through 19: Rough mechanicals in progress.

Lots 20 through 26; Commence kitchen cabinets lot 20, tile work in progress 21 through 26.

Project schedule to be prepared by WDC upon receipt of schedule for utility work;

DELCORA

Catania Engineering (City Engineer) completed review and issued approval letter to Union Square Homes and DELCORA

Colin Dawson delivered sewer connection permit application to DELCORA.

After this meeting Colin Dawson discussed with Chris Hilditch of DELCORA; "project planning module" for final PADEP approval will be prepared by DELCORA Thursday 9-18-2008. When complete Colin Dawson will pick-up from DELCORA and circulate for sign-off to Chester City Planning, Delaware County Planning then PADEP in Norristown.

PECO

PECO advised Dan Thomer that if electric service main is not commenced by October 5, 2008, PECO may reschedule and the possibility exists for electric installation to be delayed until the spring.

HC Accessible Units

Lisa Gaffney requested identification of the required 2 HC accessible units; Colin Dawson advised that all the units are HC adaptable with blocking installed in the 1st floor bathroom for grab bar installation. Harold Thomas advised that prospective HC buyers have been identified for lots 14 and 26, upon completion of the agreement of sale; WDC and Colin Dawson will meet with the prospective buyers and arrange for adaptation to the kitchen and 1st floor bathroom to accommodate the buyers specific needs.

Homeowner move-in;

Colin Dawson advised that prospective homeowner should be made aware that the project will be an active construction site until all units have been complete, rear yard access for construction activity will delay installation of rear yard fences.

Prepared by Colin Dawson RAProject photographs and Field Reports available at; http://unionsquarechesterpa.blogspot.com/
Lots 7 through 1, 4th Street4th Street and Union Street rearLots 13 through 8 Union Street north sideLots 19 through 14 Union Street south side3rd Street and Union Street rearLots 26 through 20 3rd Street Lot 7 insulation in progress
Lot 6 insulation in progress

Lot 5 insulation on site Lot 20 1st floor bathroom tile

Lot 20 kitchen floor tile

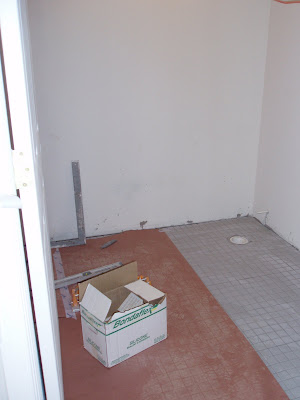

Lot 21 1st floor bathroom shower tile prep Lot 21 kitchen floor tile Lot 22 1st floor bathroom shower floor tile
Lot 22 kitchen floor tile
Lot 22 vestibule tile
Lot 22 2nd floor hall bathroom tile Lot 22 2nd floor bedroom bathroom tile
Lot 23 trim and prime paint complete Lot 23 kitchen floor tile in progress
Lot 24 trim and prime paint complete Lot 25 trim and prime paint complete
Lot 26 prime paint 1st coat complete, 2nd coat in progress
